Field-tested information for industrial millwrightsExperience in the trade since 1995

Rigging field guide

Practical Rigging & Lift Planning

A field-focused guide to planning the pick, selecting and inspecting the rigging system, controlling the load and landing it without improvising around unknown weight, center of gravity or capacity.

Opens the print dialog; select “Save as PDF.”

Field guide: https://millwrightsupply.com/rigging-lift-planning-guide.html

Know the loadWeight, center of gravity, pick points and travel path come before hardware selection
Rate the systemEvery sling, fitting, hoist and support must suit the actual configuration
Inspect each shiftIdentification and condition must be acceptable before the equipment is used
Control the areaCommunication, line-of-fire control and a planned landing protect the crew

Plan before touching the load

Build the lift around known information

A lift plan connects the load, lifting equipment, rigging configuration, people, route and landing point. The plan must be specific enough that the crew is not solving weight, capacity, clearance or communication problems while the load is suspended.

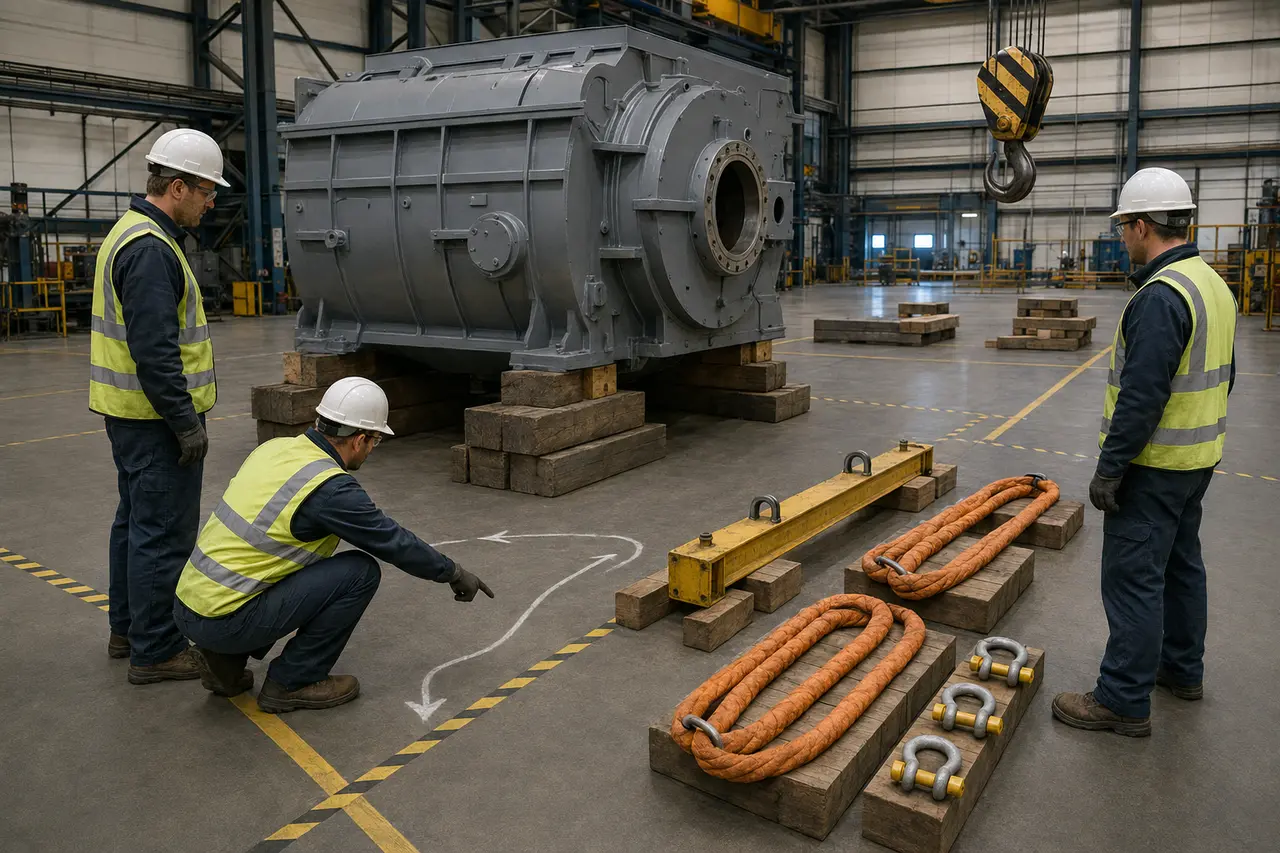

Logo-free rigging crew reviewing a supported industrial load and disconnected rigging
Pre-lift review: The load remains supported and the rigging remains slack while the crew confirms the arrangement, route and landing plan.
Load-path planning diagram

Every connection and destination must be known

Lifting device and capacity
Rigging assembly and configuration
Approved lifting points
Load, weight and center of gravity
Prepared landing support
Plan the complete system: The lowest applicable capacity and the actual configuration control the lift; keep personnel outside the line of fire and exclusion area.
  1. Define the loadConfirm the actual item, verified weight, dimensions, center of gravity, attachment points, condition and anything that can shift, drain or detach.
  2. Define the movementIdentify the starting support, lift height, travel path, orientation changes, obstructions, floor or ground limits and final landing arrangement.
  3. Choose the lifting methodSelect the crane, hoist, gantry, jack or other approved system whose rated capacity and operating range suit the complete move.
  4. Engineer special conditionsEscalate unknown weight, questionable lifting points, unusual centers of gravity, multiple lifting devices, personnel exposure or custom lifting accessories.
  5. Assign qualified rolesConfirm who directs the lift, operates equipment, rigs the load, signals, controls tag lines and has authority to stop the operation.
  6. Hold a pre-lift briefingWalk down the plan with the crew, including the first movement, stop signal, exclusion area, communication method and response to a changing condition.
Field principle

If the weight, center of gravity, lifting point, capacity or communication method is uncertain, the lift is not ready. Stop and resolve the uncertainty before loading the rigging.

One connected system

Select every component for the actual configuration

Capacity is not the number printed on one sling. It is the capacity of the complete configured system after hitch, angle, load shape, attachment, environment and support conditions are considered under the approved plan.

Manual chain hoist
Raise and lower

Hoists and lifting devices

Confirm rated load, lift, headroom, suspension, brake condition, controls and supporting structure. The support must be approved for the imposed load.

Explore manual hoists
Synthetic web slings
Connect the load

Synthetic web slings

Useful where surface protection and flexibility matter. Protect against sharp edges and remove damaged or unidentified slings from service.

Explore web slings
Synthetic round slings
Flexible high capacity

Roundslings

Check the identification, cover, core condition, fittings and edge protection. A damaged cover can expose a load-bearing core that cannot be judged casually.

Explore roundslings
Alloy chain slings
Durable assemblies

Alloy chain slings

Verify grade, tag, reach, fittings and manufacturer limits. Inspect links and attachments for wear, stretch, deformation, heat damage and unauthorized repair.

Review sling selection
Rigging shackles
Rated connections

Shackles and hardware

Use the correct body, pin and loading direction. Confirm markings, fit, pin engagement, side-loading restrictions and compatibility with the connected components.

Explore shackles
Spreader bars and lifting beams
Manage geometry

Beams and spreaders

Use only identified, rated and approved lifting devices. Confirm orientation, pick points, rigging geometry and any proof-test or engineering requirements.

Review rigging selection

Geometry changes force

Control center of gravity, sling angle and stability

Center of gravity

  • Place the hook over the planned lifting point
  • Arrange the rigging so the load cannot roll or tip unexpectedly
  • Use a controlled trial lift to confirm balance

Sling angles

  • Lower sling angles increase leg tension
  • Use the manufacturer table or approved calculation
  • Do not estimate capacity from appearance

Load attachment

  • Use verified lifting points and correct hardware
  • Protect slings from edges and damaging surfaces
  • Secure loose parts and prevent internal movement

Support and structure

  • Confirm beams, clamps, trolleys and anchor points are approved
  • Check load path through every support
  • Do not assume building steel is a lifting point

Tag lines and control

  • Use them only where the plan calls for them
  • Keep hands and body away from pinch and crush zones
  • Never wrap a tag line around the body

Trial movement

  • Take strain slowly and pause just clear of support
  • Check balance, rigging seating and brake response
  • Land the load if any condition is not as planned

Before each shift and during use

Inspect identification, condition and configuration

OSHA requires rigging equipment for material handling to be inspected before use on each shift and as necessary during use, with defective equipment removed from service. Manufacturer criteria and the applicable employer inspection program control the decision.

EquipmentPre-use focusStop / remove from service
Synthetic web slingLegible identification, webbing, stitching, eyes, fittings and edge protectionCuts, tears, broken stitching, burns, chemical damage, knots, exposed warning yarn or doubtful strength
RoundslingTag, cover, core feel, fittings and protection at contact pointsVisible core, cut or heat-damaged cover, knots, abnormal lumps, damaged fittings or missing identification
Chain slingTag, link shape and wear, free articulation, hooks, master links and repairsStretch, bent or cracked links, gouges, heat damage, weld spatter, binding links or unauthorized repair
Wire-rope slingIdentification, rope body, lay, end terminations, fittings and lubrication conditionKinking, crushing, bird-caging, corrosion, broken wires beyond criteria, heat damage or distorted fittings
Shackles and hardwareMarkings, body, pin, threads, fit and intended load directionCracks, deformation, excessive wear, damaged threads, mismatched components or illegible rating
Hoist or pullerNameplate, hook, latch, chain/rope, controls, brake, suspension and travel pathUnusual operation, slipping brake, damaged load chain/rope, distorted hook, missing rating or unsuitable support

One plan, one direction

Control communication and the work area

01

Designated direction

Identify the person who directs the movement and the qualified signal person where required. Everyone must understand the stop signal.

02

Clear fall zone

Plan positions so people remain clear of suspended loads, pinch points, load travel and the path a component would take if the rigging shifted.

03

Stop on change

Loss of communication, unexpected movement, changing weather, obstructed view, interference or a questionable sound is a reason to stop and reassess.

From pre-lift to landing

A disciplined field sequence

1

Plan and inspect

Verify the load, route, capacities, components, roles and exclusion area.

2

Take strain and trial

Lift only enough to confirm balance, seating, clearance and control.

3

Move and land

Maintain communication, avoid shock loading and land on prepared support.

  1. Walk down the complete moveVerify the load, route, headroom, support, destination, personnel positions and equipment access.
  2. Inspect and stage the systemCheck every component, protect it from damage and keep unused rigging outside the work area.
  3. Connect without forcingSeat hooks, pins, slings and fittings correctly; do not hammer mismatched hardware or side-load components not intended for it.
  4. Take strain and trial liftRaise only enough to confirm balance, seating, clearance and control before committing to travel.
  5. Move deliberatelyMaintain communication and line-of-fire control; avoid shock loading, sudden direction changes and contact with structures.
  6. Land on prepared supportUse the planned cribbing, blocking or foundation arrangement so hands and feet never become temporary supports.
  7. Release and inspectConfirm the load is stable before slackening, then inspect equipment after unusual loading or any event that could have caused damage.
  8. Close the liftStore equipment correctly, quarantine defects and document the lift or inspection records required by the employer.

Primary references

Standards and manufacturer guidance

This guide is an orientation, not a lift plan or qualification. Applicable law, the employer's program, engineered lift documents and manufacturer instructions control.

Millwright tool questions

Frequently asked questions

Practical answers for comparing tools, planning the work and choosing equipment for the actual assignment.

What information belongs in a millwright lift plan?

A lift plan identifies the verified load and center of gravity, lifting points, rigging arrangement, capacities and angles, equipment and support conditions, travel path, landing area, roles, communication, hazards and stop criteria. The required level of engineering and approval depends on the lift and site rules.

Who is responsible for directing an industrial lift?

Roles must be assigned by the employer and site under the applicable procedure. The designated lift director, qualified rigger, signal person, equipment operator and crew each have defined responsibilities; anyone who sees an unsafe condition should communicate and stop work as authorized.

When should tag lines be used on machinery lifts?

Use tag lines only when the lift plan identifies that they improve load control without creating entanglement, pinch, electrical or line-of-fire exposure. Their material, attachment and handling position must suit the load, environment and procedure.

What rigging must be inspected before a lift?

Inspect every hoist, sling, shackle, hook, clamp, beam device, attachment and control component required by the plan, including identification and condition. Remove equipment with damage, missing markings or uncertain status from service and follow the manufacturer and site inspection criteria.

Continue into the directory

Compare the rigging equipment groups

Use the Rigging Equipment directory for sling, hoist, shackle, clamp and machinery-moving categories.

Browse Rigging Equipment
